Airfield Construction
5.6.2019 9:28am local (by: MRL)
HOTEL HANGAR ROW, H1 through H4 ROOF REPLACEMENT
COMPLETED 07.19.2019
Project Start Date: Tuesday, June 4, 2019
Project Cost: $390,000.
Project General Contractor: Garland/DBS, Inc.
Project Estimated Completion Date: Friday, June 28, 2019 (due to weather, rain at start and high winds) now scheduled for 7/19/2019.
Impacted areas:
- Hotel row hangars 1-4 (tenants will be displaced)
- No restrictions to taxiing aircraft traffic is expected
- Construction materials, vehicles and equipment storage will be on the east side of the hotel row
5.3.2019 2:53pm local (by: MRL)
HANGAR 1 - SEWER LINE INSTALLATION (replaces existing septic tank w/ a gravity feed sewer line)
COMPLETED 6.14.2019
Project start date: Tuesday, May 07, 2019
Project cost: $240,000.
Project General Contractor: Sierra Nevada Construction., Inc.
Project Estimated Completion Date: Friday, June 7, 2019
Impacted areas:

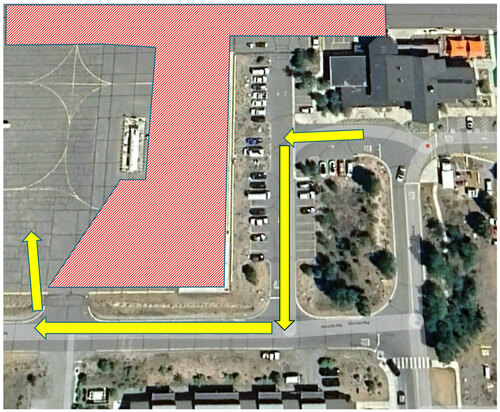

- Jetway closure (taxilane between Hgr 1-westside and the old Hgr 2 area)
- Gate 7 access may at times be restricted (use gate 5 - Air Show Way by the fire station as an alternate)
- Vehicle Parking: parking stalls airside of gate 7 will be closed during construction, and employee gravel lot will be at times restricted
- Construction materials, vehicle and equipment storage will be in the gravel lot west of the Jet Ramp
